The aim of this section is to present and evaluate the range
of procurement routes available within the contemporary professional contracting
system in the UK. A procurement route can be considered as a complex suite of
relational contracts (cf Winch 1995) which charter the project coalition for a
particular project. Thus it forms "the organizational structure adopted by
the client for the management of the design and construction of a building
project" (Masterman 1992 p 1). Masterman identifies three basic groupings
of procurement routes - separated and cooperative, integrated, and management
orientated - around the mode of coordination of the design and construction
tasks. This classification will be adopted and developed for the following
discussion as the separated, integrated, and mediated routes. The reasons for
these changes will become apparent as each is appraised. Each route will be
presented in terms of its structure, as defined by the contractual
relations between the members of the project coalition, and its process
in terms of the allocation of responsibilities through the project lifecycle.
Separated Routes
The essence of the separated route is that the client
contracts with a design team, either jointly or severally, and a general
contractor independently. The architects and engineers are typically appointed,
although fee bidding is now becoming more common, while the general contactor is
selected through competitive tender, normally on a bill of quantities. The
quantity surveyor is the prime control actor for cost and time, while
conformance quality is controlled by the designers. The separated route is what
many commentators on the UK have called the traditional system, it underlies the
RIBA Plan of Work, and is most commonly deployed at present using the JCT 80

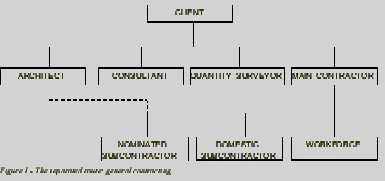

standard form of contract. A typical separated project coalition structure is
illustrated in figure 1, while the project process is captured in figure 2.
Masterman includes a number of "variants" within this classification,
such as serial contracts and cost-reimbursable contracts. However these variants
essentially refer to the manner in which the contract sum is formed, and both in
principle and in practice, can be adopted within any of the procurement routes.
The principal requirement for this route to work effectively
is for all design work to be completed prior to tender. If this requirement is
met, then the route can offer cost certainty after tender, and good quality
assurance. It also offers high transparency in the formation of the construction
contract. However this requirement is also its principal disadvantage. If design
work cannot be fully completed prior to tender, either due to time pressures, or
uncertainties in the specification, then it can lead to serious problems in
handling the inevitable variations to the contract. The route can also increase
overall project cost due to the difficulty of deploying construction expertise
during the design phase. This route is most appropriate where clients are
price-sensitive, desire to achieve high conceptual quality, and require high
standards of public accountability, and inappropriate where there are high
levels of uncertainty regarding the project mission
.
Integrated Routes
The distinctive feature of the integrated route is
that the responsibilities for the design and construction tasks rest with the

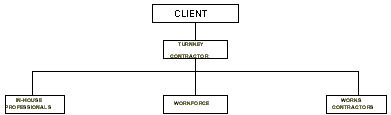

same actor. Various terms exist for this type of route - design and build;
package deal, turnkey contract and so on. Contracts are let either on a single
stage competition on the client's statement of requirements, or more commonly on
a two-stage basis in which competing contractors submit outline proposals
.
The selected contractor then develops the design until it can
be firmly priced, negotiations ensue, and a price for the remainder of the works
is agreed. The client normally retains a cost consultant or employer's agent as
a control actor to monitor the programme and budget aspects of the work, but
conformance quality responsibilities rest with the contractor. The JCT 81
standard form of contract is commonly used for this procurement route. The
principal advantages of this route are programme and budget, and a single point
of responsibility for the entire project. Integrated projects tend to be faster
and cheaper than other routes, while the integration of the designer and
constructor within one contract significantly reduces the problems of dispute
resolution. The issues of quality - conception, specification and conformance -
have been the subject of much contention, particularly from architects. However,
there is no reason, in principal, why integrated routes cannot provide high
levels of quality on all dimensions except, perhaps, that of conceptual quality.
The principal limitation of the integrated route is that the client must be able
to specify very clearly in advance what its requirements are, and variations
once the contract sum has been formed are likely to be fraught. Figure 3
provides a typical integrated project structure, while figure 4 illustrates a
typical process
.
The terms package deal and turnkey package are used to
denote variants of the integrated route, but not always consistently. The
principal additional service that can be offered is to find the site, such as is
the case under volume contracts with British housing associations. Under certain
circumstances, the contractor may also help to finance the project where full
financement is dependent upon a fully developed project. The difference between
this approach and concession contracting to be discussed later, is that the
finance is more in the form of a short-term loan than a long term equity stake.
Where the client is concerned for conceptual quality, or planning permission
problems are anticipated, an architect may be retained to do initial conceptual
work before the integrated contract is formed.

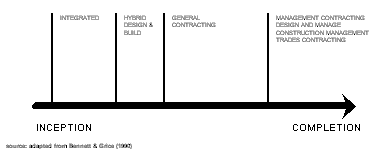

Rowlinson (1987) has identified three basic types of
contractor offering the integrated route - pure design and build, integrated
design and build, and fragmented design and build contractors. In the former
contractors offer self-contained systems to solve particular client needs. In
the second, the contractor has both design and construction management expertise
to meet the client's particular project needs. In the third, general contractors
offer packages while sub-contracting design work to architectural and
engineering practices. This last type of contractor is often associated with
what has been called "hybrid" design and build in which the design is
developed by architects and engineers up to complete definition of the project -
typically stage D of the RIBA Plan of Work - before tender. Effectively, this
approach shifts risk associated with site conditions to the contractor while
allowing the client's consultants to retain design authority. It is particularly
favoured by public sector bodies such as housing associations. The British case
study in Winch and Campagnac (1995) represents an example of hybrid design and
build. In reality this procurement route variant is more appropriately
classified as a separated one, as it fails to meet the test of the integration
of design and construction activities.
Mediated Routes
Mediated routes are
characterised by the introduction of additional actors other than those directly
responsible for the design and construction in order to provide integration to a

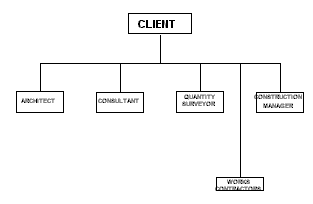

fragmented project coalition. This actor is normally designated as the
construction manager or management contractor, the main difference between the
two being the contractual arrangements between the project coalition members and
the client. The rise of mediated routes is an American importation, and largely
associated with the rapid expansion of commercial property construction during
the last decade. Their most notable feature is the separation of the
responsibility for managing the process from doing it. This has allowed the
"professionalisation" of the principal contractors' role. The
principal contractor is normally appointed, and is reimbursed either by a fee
based on the value of the works, or fixed by negotiation. Actual site work is
let in packages to trade contractors, normally by competitive tendering on a
lump sum basis. Under management contracting these trade contractors are in
contract with the principal contractor, while under construction management,
they are in contract with the client. Figures 5 and 6 illustrate these two
variants, while figure 7 identifies the process.
The main advantage of mediated routes is their ability to
cope with uncertainty in project objectives. They are particularly favoured by
clients whose main concern is the project programme, and who are willing to pay
more for a shorter elapsed time. Such additional costs are outweighed by the
reductions in the cost of capital over the shorter period. Mediated routes also
allow the client to change its objectives during the project in response to
uncertainties in the nature of the project or changing market conditions for the
services provided by the built facility. These benefits are achieved in two ways,
Firstly, the design and construction phases of the programme are overlapped to

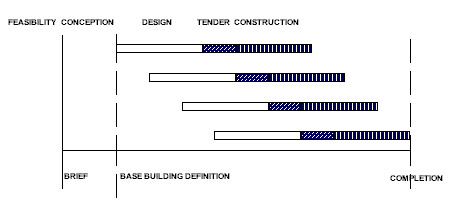

achieve reductions in overall time, a process known as "fast-tracking",
which is illustrated in figure 8. This is normally achieved by sub-dividing the
project into a series of works packages which can be designed, tendered, and let
independently. Secondly, by delaying the letting of the later packages
adjustment can be made to both programme and specification should the need
arise. Reintegration of the works packages is assured through the principal
contractor.
It is the separation of the relatively low cost project
coordination tasks from the relatively high cost site execution tasks that give
the mediated route its flexibility. Construction expertise can be obtained by
the client at relatively low cost early in the programme, while the benefits of
competitive tendering for the execution of packages on a lump sum basis can be
retained as and when requirements become fixed. This expertise is, in addition,
available for contributing to the design process. Such a contribution may be
limited to offering suggestions as to more effective details - known as
buildability - or may be more extensive. The development of design and manage,
in which construction management is extended to the design phases of the project
extends this logic further. Such construction management services may be offered
by architects or other consultants, but more commonly, such services are offered
contractors.
The principal disadvantages of the route are budgetary
control, and the burdens placed upon the client. Because the tendering of works
packages is left until relatively late, the total costs of the works are not
known until the last package is let. This can cause problems for price-sensitive
clients, particularly in the public sector. One solution is for the principal
contactor to offer a guaranteed maximum price. Secondly, the additional fee of
the principal contractor is an overhead, but this can be outweighed by the
benefits of contractor involvement in the design process. Particularly under the
construction management form, the client has additional project management
burdens due to the far larger number of contracts into which it enters. The
mediated routes are only suitable for experienced clients, and provide the
greatest benefit on complex projects, or those where it is expected there will
be a necessity to change project objectives during the programme. A particular
problem with management contracting, as opposed to the other variants, is that
it has become associated with highly opportunistic behaviour by management
contractors - especially by delaying payments to trade contractors.
The Routes Compared
Starting during the sixties, there has been a secular trend
away from separated systems. They have been characterised as slow,
conflict-prone, and inflexible. They are slow because of the necessity to
develop a full description of the project prior to tender; they are conflict
prone because of the separation of the two phases of design and construction,
and also because the architect or engineer has a conflict of interest between
its role as a designer, and its role as a control actor for quality during
construction; and they are inflexible because of the difficulties in making
variations after tender and drawing on contractor expertise during design. Both
of the other routes have grown in importance, being favoured under different
circumstances. Where clients know their requirements are not going to change,
integrated routes are preferred. They do much to eliminate conflict due to the
single point of responsibility, and tend to be faster. Where clients need
flexibility to cope with project uncertainties, then the mediated routes are
preferred. Many proponents have suggested that they are less conflict-prone as
well, but the evidence on this point is mixed (Masterman chap 5).
The three routes can be compared on five criteria - risk
allocation, flexibility, programme performance, budget performance, and quality
performance. The differences in risk allocation between the client and the
principal contractor are illustrated figure 9. Risk allocation is according to
the criterion of who accepts liability when unforeseen circumstances occur - a
typical example would be unfavourable ground conditions, and risk transfer takes
place at the formation of firm contract. As can be seen the integrated route is
most favourable for the client, while the mediated routes are least favourable,
on this criterion. Flexibility is assessed on the criteria of how easy is it to
negotiate variations to the contract should client requirements change, and how
late in the project programme fixed price contracts are formed. This is
illustrated in figure 10. Again, it can be seen that the most flexible are the
mediated routes, while the least flexible is the integrated. Clearly, there is a
trade-off in procurement route choice between flexibility and liability for
risks.
Client
objectives for the project can be categorised into three types - quality of
conception, specification, and realisation. The quality of realisation has two
aspects, the level of service offered in terms of programme, budget, and
conformance quality, and the capability to keep to that offer (Usmani and Winch
1993). So far as quality of conception is concerned, separated routes are most
favoured, because they allow the time and autonomy that leading designers
require to develop their ideas while also offering the means to ensure that what
is built rigorously conforms to that conception, but the mediated routes are not
necessarily inimical to this. Integrated routes tend to perform poorly here due
to the problems of designing to a cost, and retaining top level designers within
an integrated organisation. So far as quality of specification is concerned,
this is largely a technical matter, and should not be degraded by procurement
route, however, the ability to value engineer within the integrated and mediated
routes favours these from this point of view. So far as quality of realisation
is concerned, the integrated and mediated routes offer shorter programmes over
the project life cycle, while the integrated route offers lower budgets. The
apparent advantages of the separated routes here, tends to be due to a tendency
for the existing research to focus upon contract sum rather than total project
cost. Mediated routes can also offer low budgets if value engineering is
practised. There is no difference in principal between the routes in the levels
of conformance quality attainable. So far as control against these objectives is
concerned, separated routes have a poor reputation due to their diffused risk
allocation, while integrated routes offer the best performance overall. The
mediated routes are intended to be much more flexible, and so it would not be
expected that they would offer the same level of performance. However, their
record on programme performance has been impressive. Integrated routes have been
criticised for their low conformance quality due to the lack of independent
quality control, although there is little systematic evidence on this point.
Despite their considerable variation, these three routes
share common features of the professional system. In an important sense, the
mediated systems represent the apotheosis of the professional system. They
attempt to place the principal contractor and its employees in the same
status-group as the other professions by placing them in an independent advisory
role to the client. This tendency is reinforced by the growth of the Chartered
Institute of Building, which received its charter in 1980. Lump sum competitive
tendering is then confined to the works packages. This may appear superficially
similar to the trades system, but the crucial difference lies in the
risk-transfer that lump sum tenders allow compared to after-measurement.
Mediated systems can also be seen as a way of coping with the growing
fragmentation engendered by attempts to adapt the separated system to the
growing complexity and more demanding quality of realisation criteria of
contemporary construction through greater coordination. This coordination takes
place externally to the actual value-adding processes of design and construction
through the emergence of actors specialising in such mediation. The value adding
processes themselves are not re-integrated.
Bowley (1966 chap 16) advocated integrated routes as her
solution to the problems of the British system generated by the reliance on
separate responsibility for design and construction. Considerable movement has
occurred in this direction. Many firms offer complete building systems to meet
particular industrial requirements, while a number of integrated design and
build firms compete successfully to meet more demanding client requirements.
Predictions of future developments suggest a bright future for such routes.
However, it is not clear from the aggregate data how much of this shift is
towards the hybrid type which was considered above be more of a separated route.
Many of the competitors in the market are what Rowlinson called the fragmented
type. What is clear at present, is that few now believe that integrated routes
of themselves can solve the main problems of the industry because of the
problems they have in coping with the inherent uncertainties of the construction
process.
|
